Professional Quoting for Electrical Jobs: A Complete Guide for UK Electricians

  • Technical review: Thomas Jevons (Head of Training, 20+ years)
  • Employability review: Joshua Jarvis (Placement Manager)
  • Editorial review: Jessica Gilbert (Marketing Editorial Team)
Illustrated electrician onsite holding professional quote with icons showing detailed scope, clear itemisation, client agreement, and written documentation
Clear documentation, structured itemisation, and transparent client communication form the foundation of professional electrical quoting and dispute prevention

Professional electrical quoting represents one of the most challenging business skills electricians develop, yet it receives minimal attention during training. Most electricians learn NVQ competencies, BS 7671 regulations, and testing procedures but enter self-employment unprepared for the complexity of translating technical work into formal written quotes managing both customer expectations and business risk.

The distinction between adequate and professional quoting determines business success more than technical skill differences. Disputes, late payments, unpaid extras, and scope creep overwhelmingly stem from quoting failures rather than workmanship problems. Customer complaints about “electrician didn’t do what they promised” or “they charged for things not agreed” typically trace back to vague quotes creating mismatched expectations before work began.

This isn’t about complicated legal language or defensive quote-writing protecting electricians at customer expense. Professional quoting serves both parties: customers receive clear understanding of what they’re buying, electricians establish defined scope preventing unpaid work and managing inevitable unknowns in electrical installations.

The UK electrical trade carries unique quoting challenges distinguishing it from general building work. Regulatory compliance (BS 7671, Building Regulations Part P, Electricity at Work Regulations 1989) creates non-negotiable requirements. Hidden infrastructure behind walls and under floors generates uncertainty. Mandatory testing and certification adds time often underestimated. Safety responsibilities mean electricians cannot ignore dangerous conditions discovered mid-job even when not included in original quote.

Understanding the distinction between estimates and quotations, how to define scope professionally, what assumptions and exclusions prevent disputes, and when fixed-price quotes are inappropriate enables electricians to quote with confidence. This protects profitability while building customer trust through transparency rather than vagueness.

This guide examines: why electrical quoting differs fundamentally from other trades, what professional quotes accomplish beyond stating prices, common failure points causing disputes and payment problems, how to manage risk through clear documentation rather than price padding, essential components every professional quote requires, and practical strategies for handling variations and unknowns.

Why Electrical Quoting Differs From Other Trades

Electrical work carries specific challenges making quoting more complex than many other construction trades.

Hidden infrastructure and concealed conditions:

Unlike external work where scope is visible, electrical installations exist predominantly behind walls, under floors, and inside ceiling voids. This creates fundamental quoting uncertainty:

What you cannot see:

  • Condition of existing wiring (modern PVC, aging rubber, deteriorated fabric insulation)
  • Cable routes and accessibility (logical paths versus random chases)
  • Junction box locations and conditions (accessible versus buried under plaster)
  • Earthing arrangements (proper bonding versus missing or corroded connections)
  • Consumer unit condition (modern RCBO protection versus 1970s rewireable fuses)
  • Load capacity of existing circuits (adequate for additions versus already overloaded)

The quoting problem:

Customer requests “add three sockets in living room” appears straightforward. Professional quote must assume existing installation meets minimum safety standards to accept new work. However, opening walls might reveal:

  • No earth conductor on existing circuit
  • Insufficient circuit capacity for additional sockets
  • Non-compliant wiring requiring replacement
  • Borrowed neutrals creating dangerous conditions
  • Consumer unit lacking RCD protection for new socket positions

Discovering these conditions mid-job creates dilemma: proceed unsafely, absorb costs of unexpected remedial work, or halt job to renegotiate price. Professional quotes address this through clear assumptions and exclusion clauses rather than hoping problems don’t exist.

Compare to decorator quoting to paint room: walls, ceiling, woodwork all visible. Condition assessment straightforward. Scope defined easily. Electrical work lacks this visibility advantage.

Regulatory compliance burdens creating non-negotiable costs:

Electrical work operates under strict legal framework other trades don’t face:

Regulatory requirements:

  • BS 7671 Wiring Regulations: Technical standards for electrical installations. Deviations must be justified. Courts reference BS 7671 in determining compliance with Electricity at Work Regulations.
  • Building Regulations Part P (England and Wales): Notifiable work requires compliance certification. Non-compliance can prevent property sales, invalidate home insurance, result in enforcement action.
  • Electricity at Work Regulations 1989: Places legal duties on persons performing electrical work. Serious breaches can result in criminal prosecution, unlimited fines, imprisonment.

Quote implications:

These aren’t optional “best practices” electricians can omit to compete on price. They’re legal requirements adding time and cost to every job:

  • Testing and certification not optional extras but mandatory requirements
  • Discovered safety issues cannot be ignored without violating duty of care
  • Work must be notifiable to Building Control or through competent person scheme
  • Certification must be issued documenting compliance

Professional quotes must include and itemize these regulatory costs. Customers comparing quote from qualified electrician (£800 including testing, certification, notification) to handyman (£400 with none of these) need education about why price differs. Quote should explain these requirements rather than assuming customer understands.

Mandatory testing adding time often underestimated:

Every electrical installation or alteration requires inspection and testing to BS 7671 standards before energizing. This adds significant time beyond physical installation work:

Testing requirements:

  • Continuity testing (R1+R2 values for every circuit)
  • Insulation resistance testing (minimum 1MΩ between conductors)
  • Polarity verification (correct live/neutral connections)
  • Earth fault loop impedance testing (adequate for protective device operation)
  • RCD testing (correct operation at rated residual current)
  • Functional testing (all installed equipment operates correctly)

Time requirements:

  • Simple circuit addition: 30-45 minutes testing and documenting results
  • Consumer unit replacement: 60-90 minutes testing all circuits
  • Partial rewire: 90-120+ minutes depending on circuits affected
  • Complete rewire: 3-6 hours comprehensive testing and documentation

Quote implications:

Inexperienced electricians quote installation time (£400 for 6 hours physical work) but forget 90 minutes testing and certification (another £100+ value). Professional quotes itemize testing separately showing it as regulatory requirement not optional add-on. This prevents customer questioning “why are you spending time testing when I hired you to install?”

Professional liability and duty of care:

Electricians carry legal responsibilities distinguishing electrical work from non-safety-critical trades:

Liability framework:

  • Signature on electrical certificates declares work complies with regulations and safety standards
  • Discovering dangerous conditions creates duty of care to inform customer and refuse unsafe work
  • Mistakes causing fires, injuries, or fatalities can result in criminal prosecution, civil liability, insurance claims
  • Professional indemnity insurance essential but doesn’t eliminate personal accountability

Quote implications:

This liability means professional quotes must include protective language:

  • “Subject to existing installation meeting current safety standards”
  • “Any discovered safety issues will be reported and require resolution before completing new work”
  • “Quote assumes adequate earthing and bonding arrangements exist”

Without these clauses, electrician either works dangerously (ignoring discovered faults) or absorbs unexpected costs (replacing non-compliant consumer unit not included in original quote). Neither option acceptable.

Access and disruption challenges:

Electrical work often requires invasive access other trades don’t need:

Access requirements:

  • Lifting floorboards to access cables
  • Cutting holes in walls and ceilings for cable routes
  • Isolating power affecting entire property or sections
  • Testing requiring all circuits powered down
  • Access to confined spaces (lofts, under-floor voids)

Quote implications:

Professional quotes must address:

  • Who provides access (customer moves furniture, lifts carpets, provides ladder access to loft)
  • Extent of disruption (power off periods, access to all rooms)
  • Making good after work (filling holes, redecorating, replacing floorboards)
  • Assumptions about site conditions (clear access, safe working platforms, adequate lighting)

Vague quotes saying “rewire kitchen” without defining access expectations lead to disputes when customer hasn’t moved furniture or electrician needs power isolated longer than customer expected.

Projects involving complex electrical requirements like kitchen extension electrical requirements particularly benefit from detailed quoting addressing unknowns upfront rather than discovering them mid-project.

Electrician preparing professional written quote demonstrating business documentation practices
Professional quoting is business skill as important as technical competence for self-employed electrician success

What Professional Quotes Accomplish Beyond Stating Price

Effective quotes serve multiple functions beyond simply communicating cost.

Function 1: Establishing clear scope and defined boundaries

Professional quotes precisely define what is included in the price, creating shared understanding between electrician and customer:

Scope definition elements:

Installation work specified:

  • Exact quantities: “Install 6x double sockets” not “install sockets”
  • Specific locations: “Three sockets in living room, two in dining room, one in hallway”
  • Material specifications: “13A double sockets, white plastic, standard profile”
  • Circuit details: “Extend existing ring final circuit” or “New radial circuit from consumer unit”

Testing and certification itemized:

  • “Inspection and testing to BS 7671:2018+A2:2022”
  • “Issue of Minor Electrical Installation Works Certificate” or “Electrical Installation Certificate”
  • “Building Regulations compliance notification” (where applicable)

Making good defined:

  • “Fill cable chases and apply skim coat plaster (customer to arrange final decoration)”
  • “Replace lifted floorboards and carpet” or “Replace lifted floorboards (customer to relay carpet)”

Why precision matters:

Vague scope (“rewire kitchen £2,500”) allows customer to assume different things included than electrician intended. Dispute emerges at completion when customer expected outside light, new consumer unit, or smoke alarms not mentioned in quote.

Precise scope (“Install 8x double sockets, 4x ceiling lights with switches, 1x cooker circuit with 45A switch, extend existing circuits – does NOT include new consumer unit, smoke alarms, or external lighting”) prevents these disputes. Both parties understand exactly what £2,500 includes.

Function 2: Allocating risk through assumptions and exclusions

Professional quotes identify what is assumed about site conditions and explicitly exclude work outside defined scope:

Standard assumptions:

Site condition assumptions:

  • “Existing electrical installation in satisfactory condition meeting BS 7671 standards”
  • “Adequate circuit capacity exists for additional load”
  • “Earthing and bonding arrangements compliant with current standards”
  • “Clear, unobstructed access to all work areas”
  • “Customer provides adequate lighting and power for tools”

Access and disruption assumptions:

  • “Customer removes furniture and floor coverings as necessary”
  • “Customer arranges alternative accommodation if full power isolation required”
  • “Work can proceed continuously without delays”

Why assumptions matter:

These aren’t defensive language protecting electrician unreasonably. They clarify baseline conditions quote relies upon. If assumptions prove incorrect (existing wiring non-compliant, customer hasn’t moved furniture), variation process triggers before proceeding.

Without assumptions, customer might believe electrician should absorb all discovered problems within quoted price. Professional quotes allocate risk fairly: electrician responsible for quoted work, customer responsible for site conditions and discovered issues outside scope.

Standard exclusions:

Work explicitly not included:

  • “Decorative finishing and painting”
  • “Structural alterations or making good requiring builder/plasterer”
  • “Replacing existing consumer unit (unless specifically itemized)”
  • “Remedial work on existing installations”
  • “Moving heavy furniture or appliances”
  • “Dealing with asbestos or other hazardous materials requiring specialist contractors”

Why exclusions matter:

Exclusions aren’t evasions or unprofessional. They clarify boundaries preventing misunderstandings. Better to state upfront “quote doesn’t include new consumer unit” than have customer assume it’s included and dispute price at completion.

Exclusions also protect against scope creep. Customer requests additional work mid-job, electrician references exclusions and provides separate variation quote rather than absorbing unexpected work.

Function 3: Providing transparency and building trust

Competition and Markets Authority (CMA) guidance requires price transparency in commercial practices. Professional quotes comply while building customer confidence:

Transparency requirements:

Price presentation:

  • Total price inclusive of VAT (if VAT registered)
  • Or clear statement of VAT rate and how to calculate total
  • No hidden costs or “drip pricing” (adding fees at end)
  • Payment terms clearly stated

Itemization showing value:

  • Materials and labor separated (or combined per line item)
  • Testing and certification as separate line showing regulatory requirement
  • Any provisional sums (items awaiting customer selection)

Why transparency builds trust:

Customers comparing quotes appreciate understanding what they’re paying for. Detailed quote showing:

  • Materials: £300
  • Installation labor: £800
  • Testing and certification: £150
  • Total: £1,250 + VAT

…provides more confidence than single line “Electrical work £1,250 + VAT” with no breakdown.

Transparency demonstrates professionalism. Customer sees electrician has thought through job systematically rather than guessing round number.

Function 4: Preventing disputes through documented agreement

Written quotes create reference point when disagreements emerge:

Dispute scenarios prevented by professional quotes:

Scenario 1: “You didn’t finish the job”

  • Customer: “You didn’t install outside light I asked for”
  • Electrician references quote: “External lighting explicitly excluded in scope”
  • Resolution: Customer either accepts work is complete per quote or requests variation for additional work

Scenario 2: “This wasn’t supposed to cost extra”

  • Customer: “Why are you charging more to replace consumer unit?”
  • Electrician references assumptions: “Quote assumed existing consumer unit compliant. Testing revealed it lacks RCD protection required before adding new circuits. Replacement not included in original scope.”
  • Resolution: Documented variation process rather than heated argument

Scenario 3: “You’re taking too long”

  • Customer: “Why are you still testing when I hired you to install sockets?”
  • Electrician references itemized quote: “Testing and certification itemized separately showing it’s regulatory requirement for all electrical work”
  • Resolution: Customer understands testing is part of professional service, not electrician wasting time

Function 5: Educating customers about professional standards

Quotes serve educational purpose explaining why qualified electrician costs more than handyman:

Educational elements in professional quotes:

Regulatory requirements explained:

  • Brief note: “All electrical work must comply with BS 7671 Wiring Regulations and Building Regulations Part P”
  • Testing explanation: “Inspection and testing required to verify safe installation before energizing”
  • Certification importance: “Electrical certificate required for property sale, insurance, and safety compliance”

Why education matters:

Customer comparing £800 quote (qualified electrician with testing, certification, notification) to £400 quote (handyman with none of these) needs to understand difference isn’t just price but legal compliance and safety.

Professional quotes briefly explain these requirements, positioning electrician as knowledgeable professional rather than expensive tradesperson doing same work as cheaper alternatives.

"Learners quote for installation time but forget testing and certification. Every job requires inspection and testing to BS 7671 standards - that's 30-90 minutes depending on complexity. Then there's completing certification, explaining results to customers, addressing any test failures. Professional quotes itemize testing separately showing it's not optional add-on but regulatory requirement. This educates customers about why qualified electricians cost more than handymen."

Common Quoting Failure Points Causing Disputes

Understanding typical mistakes enables avoiding them systematically.

Failure Point 1: Relying on verbal agreements rather than written documentation

The most common quoting failure is discussing work verbally without written confirmation:

Typical scenario:

  • Customer calls: “Can you add three sockets in living room?”
  • Electrician visits, discusses job, mentions £400
  • Customer says “yes, go ahead”
  • Electrician starts work without written quote
  • Disputes emerge about what was included, access requirements, or timeline

Why this fails:

Human memory unreliable. Both parties remember conversation differently. Customer recalls electrician saying “I’ll sort everything out” interpreting that as including new consumer unit. Electrician recalls customer saying “just add sockets to existing circuit” excluding any consumer unit work.

Without written documentation, dispute becomes he-said-she-said with no objective reference point. This creates payment delays, customer complaints, and damaged reputation.

Professional alternative:

Follow verbal discussion with written quote (email acceptable, formal quote document better) confirming:

  • Scope discussed
  • Price quoted
  • Assumptions made during site visit
  • Exclusions clarified
  • Payment terms

Request customer written acceptance (email reply “I accept quote” sufficient, signed quote document better) before starting work. This takes 15-30 minutes but prevents hours of dispute resolution.

Failure Point 2: Vague scope descriptions enabling scope creep

Imprecise scope language creates ambiguity exploited unintentionally by customers:

Vague scope examples:

“Rewire kitchen” – What does this include?

  • New consumer unit?
  • Smoke alarms?
  • Outside light?
  • Cooker circuit?
  • How many sockets?
  • Ceiling lights or just socket circuits?

“Upgrade electrics” – Upgrade what specifically?

  • Full rewire?
  • Consumer unit replacement only?
  • Add RCD protection?
  • Replace damaged accessories?

“Electrical work to extension” – Define what work:

  • First fix (cables in walls)?
  • Second fix (accessories installed)?
  • Testing and certification?
  • Integration with existing circuits?

Why vagueness fails:

Customer fills in blanks with their assumptions. Electrician fills in blanks with their assumptions. These rarely align perfectly. Dispute emerges when work completed doesn’t match customer expectations despite matching electrician’s interpretation.

Professional alternative:

Itemize everything specifically:

  • Quantities: “Install 8x double sockets”
  • Locations: “4x in kitchen, 2x in dining room, 2x in hallway”
  • Circuit details: “Extend existing ring final OR Install new radial circuit from consumer unit”
  • Accessories: “White plastic face plates, standard profile”
  • Exclusions: “Does NOT include new consumer unit, smoke alarms, or external lighting”

Yes, this creates longer quote. But clarity prevents disputes worth far more than time spent writing detailed scope.

Failure Point 3: Omitting assumptions about site conditions

Failing to state assumed conditions creates expectation electrician will handle all discovered problems:

Missing assumptions creating problems:

Access assumptions not stated:

  • Electrician expects customer to move furniture
  • Customer expects electrician to work around furniture
  • Dispute emerges when electrician requests furniture moved mid-job

Existing installation assumptions not stated:

  • Electrician assumes existing circuits compliant and adequate
  • Testing reveals non-compliant consumer unit requiring replacement
  • Customer expects electrician to complete job within quoted price despite unexpected work

Timeline assumptions not stated:

  • Electrician assumes continuous work access
  • Customer unavailable for several days mid-project
  • Timeline extends, customer complains about delays

Professional alternative:

Include standard assumptions section in every quote:

  • “Customer provides clear access to work areas, moves furniture and floor coverings as necessary”
  • “Existing electrical installation meets current safety standards”
  • “Work can proceed continuously without customer-caused delays”
  • “Adequate lighting and power available for tools”

When assumptions prove incorrect, documented variation process triggers rather than absorbing unexpected costs or arguing with customer.

Failure Point 4: Failure to document and charge for variations

Electrician does additional work requested mid-job without formal variation:

Typical scenario:

  • Quote covers installing 8 sockets in kitchen
  • Customer mid-job: “Can you also install three sockets in garage while you’re here?”
  • Electrician agrees verbally and does work
  • Final invoice includes garage work
  • Customer: “You didn’t quote for garage, why am I being charged?”

Why this fails:

Customer doesn’t understand additional work costs extra when electrician verbally agreed without discussing price. Electrician feels exploited working for free. Dispute damages relationship and creates payment delay.

Professional alternative:

Implement variation procedure stated in original quote:

  • “Any changes to scope require written variation agreement before proceeding”
  • When customer requests additions, provide written variation: “Additional work: Install 3x double sockets in garage. Materials £80, labor £150, total £230 + VAT. Adds 1 day to timeline.”
  • Obtain customer written acceptance before doing additional work
  • Separate variation from original invoice or clearly itemize showing base quote + variations

This protects profitability while maintaining professional relationship through transparency.

Failure Point 5: Underestimating testing time and regulatory requirements

Inexperienced electricians quote installation labor forgetting testing, certification, and notification:

What gets forgotten:

  • 30-90 minutes testing depending on job complexity
  • 30-60 minutes completing certification paperwork
  • 15-30 minutes explaining results and certificate to customer
  • Building Control notification and associated administration
  • Dealing with test failures requiring remediation

Real cost example:

  • Installation work: 6 hours at £40/hour = £240
  • Testing and certification: 2 hours at £40/hour = £80
  • Materials: £200
  • Total: £520

Electrician quoting £400 (only accounting for installation and materials) either:

  • Loses money doing professional job correctly
  • Cuts corners on testing to stay within budget (unsafe and unprofessional)
  • Attempts to charge customer extra at completion (customer refuses, having accepted £400 quote)

Professional alternative:

Itemize testing and certification separately in every quote:

  • Installation labor: £240
  • Materials: £200
  • Testing and certification: £80
  • Total: £520 + VAT

This shows testing as regulatory requirement not optional extra. Educates customer. Protects profitability. Prevents temptation to cut corners.

Failure Point 6: Using imprecise timeline commitments

Vague timeline language creates unmet expectations:

Vague timeline examples:

  • “Will do next week” (which day? If delayed, how long?)
  • “Takes about 3 days” (consecutive days? Spread over 2 weeks?)
  • “As soon as possible” (legally undefined under Consumer Rights Act 2015)

Professional alternative:

Define timelines clearly:

  • “Work commences Monday 15th February, estimated completion Friday 19th February”
  • “Work requires 3 consecutive days, proposed dates Monday 22nd – Wednesday 24th February subject to your availability”
  • “If unforeseen issues extend timeline, customer will be notified immediately with revised completion estimate”

Clear timelines prevent customer expecting job finished in 2 days when electrician needs 5 days due to testing time or discovered issues.

For electricians moving into specialist installations like solar PV or heat pumps, professional quoting becomes even more critical due to higher complexity, longer timelines, and more opportunities for misunderstandings about scope.

Professional quotes create shared understanding before work begins, preventing disputes from mismatched expectations
Professional quotes create shared understanding before work begins, preventing disputes from mismatched expectations

Managing Risk Without Padding Prices

Professional risk management through transparent practices rather than inflated prices.

Strategy 1: Staged quoting for high-uncertainty work

Not every job suits fixed-price quoting. High uncertainty situations benefit from phased approach:

When staged quoting appropriate:

Fault-finding and diagnosis:

  • Customer reports intermittent problem (RCD tripping occasionally, some lights flickering)
  • Cause unknown without investigation
  • Time to diagnose unpredictable (might be obvious or require days of testing)

Staged approach:

  • Phase 1 quote: “Diagnostic testing to identify fault: £150 for first 2 hours, £60/hour thereafter if required. Will provide findings and quote for remedial work after diagnosis.”
  • Phase 2 quote: After diagnosis, quote for specific repair work identified

Upgrading existing installations of unknown quality:

  • Customer wants additional circuits but existing installation unseen
  • Risk of non-compliant wiring, inadequate capacity, or required upgrades

Staged approach:

  • Phase 1 quote: “Survey and test existing installation to assess capacity and compliance: £200. Will provide detailed quote for proposed work based on findings.”
  • Phase 2 quote: After survey, quote for installation work with any required upgrades itemized

Benefits of staged approach:

  • Electrician not forced into losing position (fixed quote on uncertain work)
  • Customer not surprised by unexpected costs (understood investigation phase separate from work phase)
  • Professional relationship maintained through transparency

Strategy 2: Provisional sums for customer-selected items

Some elements can’t be precisely priced when quote prepared:

Typical provisional sum scenarios:

Light fittings:

  • Customer hasn’t selected specific fixtures when quote needed
  • Prices vary dramatically (£30 basic fixture to £300+ designer fitting)

Provisional sum approach:

  • “Light fittings: £50 per fitting allowance (6 fittings = £300 provisional sum). Final cost adjusted based on actual fixtures selected. Labor rate £40/hour applies if complex fittings require additional installation time.”

Kitchen appliances or specialist equipment:

  • Customer selecting appliances separately
  • Connection requirements vary by appliance

Provisional sum approach:

  • “Appliance connections: £80 per appliance allowance based on standard installation. Adjusted if appliances require additional circuit capacity or three-phase connections.”

Benefits of provisional sums:

  • Quote can proceed before all selections finalized
  • Customer understands budget approximately
  • Avoids overestimating (losing job to competitor) or underestimating (absorbing losses)

Strategy 3: Clear variation procedures stated upfront

Professional quotes include variation policy preventing mid-job disputes:

Standard variation clause:

“Any changes to agreed scope of work require written variation agreement before proceeding. Variations will be priced individually and may affect completion timeline. Customer signature required before commencing variation work.”

Variation process in practice:

Customer requests change:

  • “Can you add outside light while you’re here?”

Electrician response:

  • Verbally: “Yes, I can do that. It’s outside original scope so I’ll provide written variation with price.”
  • Written variation: “Additional work: Install 1x external PIR floodlight including wiring from existing circuit. Materials £60, labor £120, total £180 + VAT. Adds 0.5 days to completion date.”
  • Customer signs acceptance
  • Work proceeds

Benefits:

  • Customer knows any changes cost extra before requesting them
  • Electrician not pressured to do freebies maintaining customer satisfaction
  • Both parties understand impact on timeline
  • Prevents invoice disputes

Strategy 4: Site surveys before final quotes for complex jobs

Charge for preliminary survey on complex jobs to inform accurate quoting:

When surveys appropriate:

  • Full or partial rewires (need to see existing installation)
  • Consumer unit upgrades in properties with unknown history
  • Commercial installations requiring coordination with other trades
  • Extensions or renovations with electrical work integrated

Survey approach:

Initial discussion:

  • Customer describes work required
  • Electrician explains survey needed to provide accurate quote
  • Survey fee: £150-£300 depending on complexity

Survey deliverables:

  • Written report on existing installation condition
  • Identified issues requiring resolution
  • Detailed quote for proposed work based on actual site conditions
  • Timeline estimate

Survey fee treatment:

  • Deducted from final job price if customer proceeds
  • Or standalone fee if customer doesn’t proceed (compensates electrician for time)

Benefits:

  • Eliminates guess-work reducing quote accuracy
  • Identifies problems before committing to fixed price
  • Demonstrates professionalism through thorough approach
  • Survey fee filters serious customers from those quote-shopping

Strategy 5: Conditional acceptance clauses

Include conditions that must be satisfied before quote becomes binding:

Standard conditional clauses:

Subject to satisfactory testing:

  • “Quote assumes existing installation meets current safety standards. Subject to satisfactory Earth Loop Impedance, Insulation Resistance, and RCD testing. If testing reveals non-compliance, separate quote for remedial work will be provided before proceeding with installation work.”

Subject to access and conditions:

  • “Quote assumes clear unobstructed access to all work areas, adequate lighting, and customer-provided ladder access to loft space. If site conditions differ, variation may be required.”

Subject to Building Control approval:

  • “Quote for work requiring Building Regulations approval subject to plans being accepted by Building Control. Any required modifications will be quoted separately.”

Benefits:

  • Protects electrician from unforeseen problems
  • Customer understands quote based on stated conditions
  • Variation process clear if conditions not met
  • Prevents forced choice between unsafe work and financial loss

"The electricians we place who succeed in self-employment aren't necessarily the most technically skilled - they're the ones who quote professionally. Clear scope definition, written assumptions, formal variation procedures. These business practices separate professionals from 'bloke with van' competitors. Customers pay premium rates for electricians who demonstrate this level of organization before tools leave the van."

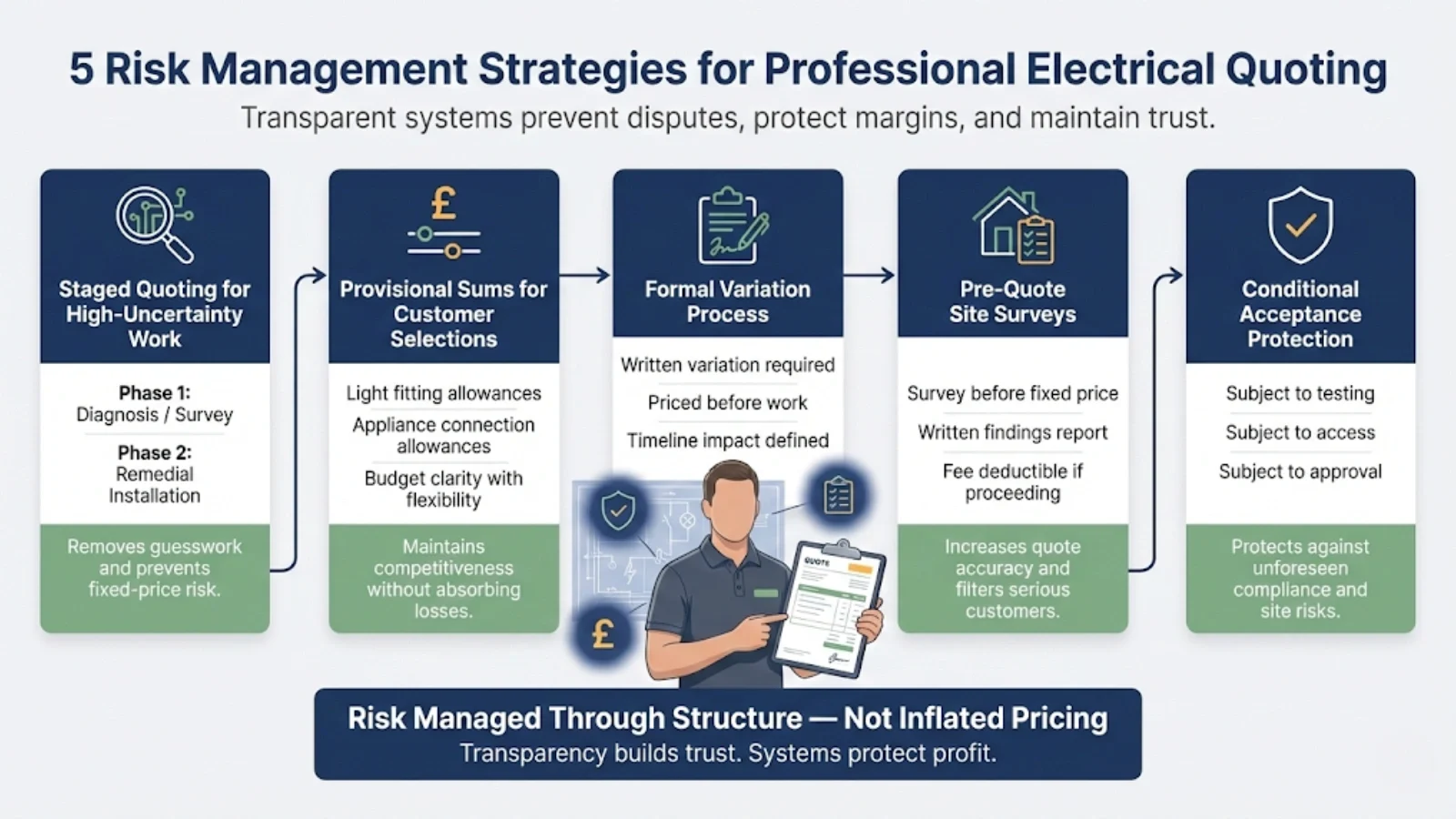

Infographic diagram illustrating five professional electrical quoting risk management strategies including staged quoting, provisional sums, formal variations, paid site surveys
Structured risk management strategies allow electricians to protect profit, maintain transparency, and prevent disputes without inflating prices

Essential Components Every Professional Quote Requires

Systematic checklist ensuring quotes include all necessary elements.

Component 1: Header information and business details

Professional presentation begins with complete business information:

Required header elements:

Business identity:

  • Trading name or company name
  • Business address
  • Contact details (phone, email)
  • Company registration number (if limited company)
  • VAT registration number (if applicable)
  • Professional affiliations (NICEIC, NAPIT, ECA, etc.)
  • Insurance details (optional but builds confidence: “Public Liability Insurance: £X million”)

Quote identification:

  • Quote reference number (for tracking and invoicing)
  • Date prepared
  • Valid until date (typically 30-90 days)

Customer details:

  • Customer name
  • Property address where work performed
  • Contact details

Why this matters:

Professional presentation builds confidence. Complete details enable customer to verify business legitimacy, contact for questions, and reference quote easily. Missing elements look unprofessional or suggest unregistered business.

Component 2: Detailed scope of work

Core of quote defining exactly what is included:

Scope detail requirements:

Itemize quantities and specifications:

  • “Install 8x 13A double sockets, white plastic, flush mounted”
  • “Install 4x LED downlights, 10W, warm white, IP20 rated”
  • “Replace existing consumer unit with 12-way dual RCD board (Hager or equivalent)”

Define locations specifically:

  • “Living room: 3x double sockets, 2x ceiling light points”
  • “Kitchen: 4x double sockets, cooker circuit with 45A switch, 2x ceiling lights”
  • “Hallway: 1x double socket, 1x light point”

Specify circuit arrangements:

  • “Extend existing ring final circuit” or “New radial circuit from consumer unit”
  • “New dedicated circuit for cooker”
  • “Lighting on new 6A MCB circuit”

Include testing and certification:

  • “Inspection and testing to BS 7671:2018+A2:2022 standards”
  • “Issue of Electrical Installation Certificate” (or Minor Works Certificate as appropriate)
  • “Building Regulations compliance notification” (where required)

Component 3: Assumptions section

Clarify baseline conditions quote relies upon:

Standard assumptions to include:

Site condition assumptions:

  • “Existing electrical installation in satisfactory condition meeting current safety standards”
  • “Adequate circuit capacity and earthing arrangements exist”
  • “Consumer unit (if not being replaced) has adequate spare ways for new circuits”
  • “Property mains supply adequate for proposed additional load”

Access and preparation assumptions:

  • “Clear, unobstructed access to all work areas”
  • “Customer removes furniture, pictures, and floor coverings as necessary”
  • “Customer provides ladder or scaffold access to high-level work”
  • “Adequate lighting and power available for tools”
  • “Customer arranges alternative accommodation if full power isolation required”

Timeline assumptions:

  • “Work can proceed continuously without delays”
  • “Customer available for access during quoted working days”
  • “Materials ordered available within standard lead times”

Component 4: Exclusions section

Explicitly state what is NOT included:

Standard exclusions to include:

Work outside scope:

  • “Decorative finishing and painting”
  • “Structural alterations or building work requiring other trades”
  • “Replacing existing consumer unit” (if not included in scope)
  • “Remedial work on existing installations beyond agreed scope”
  • “Dealing with asbestos or hazardous materials requiring specialist contractors”

Access and disruption:

  • “Moving heavy furniture or white goods”
  • “Lifting or relaying flooring except where necessary for cable access”
  • “Redecorating after making good”

Why exclusions matter:

Clearly stating what’s NOT included prevents customer assuming these are part of quoted price. Better to over-communicate exclusions than discover mid-job customer expected electrician to move washing machine, repaint walls, or replace 40-year-old consumer unit without charging extra.

Component 5: Price breakdown and payment terms

Transparent pricing building customer confidence:

Price presentation options:

Option 1: Itemized by category

  • Materials: £450
  • Labor: £950
  • Testing and certification: £180
  • Subtotal: £1,580
  • VAT (20%): £316
  • Total: £1,896

Option 2: Itemized by task

  • Socket installation (8x): £400
  • Lighting installation (4x): £280
  • Consumer unit replacement: £650
  • Testing and certification: £180
  • Materials included
  • Subtotal: £1,510
  • VAT (20%): £302
  • Total: £1,812

Payment terms clearly stated:

Typical payment structures:

For small jobs (under £1,000):

  • “Payment due on completion via bank transfer or cash”
  • “Invoice provided with completion certificate”

For medium jobs (£1,000-£5,000):

  • “30% deposit upon acceptance: £565”
  • “Balance on completion: £1,331”
  • “Total: £1,896”

For large jobs (over £5,000):

  • “30% deposit upon acceptance”
  • “40% on completion of first fix”
  • “30% on completion and certification”

Late payment terms:

  • “Payment due within 7 days of invoice date”
  • “Late payment may incur charges per Late Payment of Commercial Debts Act”

Component 6: Timeline and duration estimate

Managing expectations about work schedule:

Timeline information to include:

Estimated duration:

  • “Work estimated to require 3 days (consecutive)”
  • “Work will be scheduled across 5 working days to accommodate material deliveries and customer access”

Proposed dates:

  • “Proposed commencement: Monday 22nd February”
  • “Estimated completion: Wednesday 24th February”
  • “Dates subject to customer confirmation of availability”

Factors affecting timeline:

  • “Timeline assumes no unforeseen complications”
  • “Discovered issues may extend timeline; customer will be notified immediately”
  • “Weather-dependent external work may require rescheduling”

Component 7: Variation policy and terms

Clear process for handling changes:

Variation policy statement:

“Any changes to agreed scope require written variation agreement before proceeding. Variations priced separately and may affect completion timeline. Customer signature required before commencing variation work. Invoice will itemize original scope and approved variations separately.”

Why this matters:

Stated upfront, variation policy prevents disputes when changes requested. Customer understands from beginning that additions cost extra and require formal agreement. Electrician protected from doing unpaid extras or arguing about “I thought this was included.”

Component 8: Quote acceptance and validity

Formalizing agreement:

Acceptance mechanism:

Option 1: Signature acceptance

  • Customer signature line: “I accept the above quotation and terms”
  • Date line
  • Return signed quote to electrician

Option 2: Email acceptance

  • “Please confirm acceptance by email reply”
  • Email confirmation serves as contract

Validity period:

  • “This quotation valid for 30 days from date above”
  • “Material prices subject to change if not accepted within validity period”

Component 9: Terms and conditions reference

Legal protection through standard terms:

Standard terms to reference:

  • Liability limitations and insurance coverage
  • Dispute resolution procedures
  • Cancellation policy
  • Intellectual property (for design work)
  • Health and safety responsibilities
  • Payment terms and late payment charges

Implementation:

  • “This quote subject to our standard terms and conditions, available at [website] or upon request”
  • Or include abbreviated terms directly in quote document

For electricians developing professional business practices, improving customer communication skill development through clear documentation and transparent quoting significantly impacts business success beyond pure technical competence.

Estimate Versus Quotation: Critical Legal Distinction

Understanding difference prevents legal and financial problems.

Estimate definition and characteristics:

What an estimate is:

  • Non-binding approximation of costs
  • Used when full scope unknown or uncertain
  • Can change significantly as work progresses
  • Provides customer with budgeting guidance
  • Not contractual commitment

When estimates appropriate:

High-uncertainty work:

  • Fault diagnosis where cause unknown
  • Renovations where existing conditions hidden
  • Projects requiring design development
  • Work dependent on other trades completing first

Estimate language examples:

  • “Estimated cost: £1,500-£2,000 depending on findings”
  • “Approximate range: £800-£1,200 subject to survey results”
  • “Indicative budget: £3,000-£4,000 pending final design”

Customer expectations:

  • Understands final cost may differ
  • Accepts variation based on actual work required
  • Uses estimate for budget planning not fixed commitment

Quotation definition and characteristics:

What a quotation is:

  • Legally binding offer once accepted
  • Fixed price for defined scope
  • Can only change through formal variation process
  • Becomes contract upon customer acceptance
  • Electrician commits to completing work for stated price

When quotations appropriate:

Well-defined work:

  • Scope fully understood and visible
  • Site conditions known or surveyed
  • No significant unknowns
  • Standard installations with predictable requirements

Quotation language examples:

  • “Fixed price: £1,850 for scope as defined”
  • “Total cost: £3,200 including materials, labor, testing, certification”
  • “Quote valid for 30 days, price guaranteed upon acceptance”

Customer expectations:

  • Final price matches quote (unless scope changes)
  • Work completed as specified
  • Any changes require separate variation
  • Contract formed upon acceptance

The legal distinction matters:

Consumer Rights Act 2015 implications:

For estimates:

  • Electrician must complete work for “reasonable price” if no fixed price agreed
  • “Reasonable” determined by market rates, complexity, time taken
  • More flexibility if costs exceed estimate
  • But cannot massively exceed estimate without customer agreement

For quotations:

  • Fixed price cannot be increased without customer agreement to scope change
  • Electrician bound to complete for quoted price even if underestimated
  • Customer entitled to work for quoted price
  • Variations require mutual agreement

Risk implications:

Estimate risks:

  • Customer may dispute final cost if significantly exceeds estimate
  • “You estimated £1,500, why is it £2,800?” requires justification
  • More administrative burden documenting actual work
  • Customer might halt work mid-project if costs escalating

Quotation risks:

  • Electrician absorbs any underestimation losses
  • Discovered problems must either be absorbed or formally varied
  • Cannot simply increase price because “it took longer than expected”
  • Fixed commitment regardless of difficulties encountered

Professional practice:

Clearly label documents:

  • “ESTIMATE” or “QUOTATION” prominently displayed
  • Never use terms interchangeably
  • Explain difference to customer when providing

Choose appropriate document type:

  • High certainty = Quotation
  • High uncertainty = Estimate or staged quote
  • Don’t force quotation on uncertain work to compete on price

Transition from estimate to quotation:

Professional approach:

Phase 1: Estimate stage

  • “Estimate for diagnostic work and initial assessment: £200-£300”
  • Complete diagnosis identifying specific problem
  • Document findings

Phase 2: Quotation stage

  • “Based on diagnostic findings, quotation for repair work: £850 fixed price”
  • Customer accepts fixed-price quotation
  • Work proceeds under contract

This protects both parties: estimate covers uncertain investigation, quotation provides fixed price for known solution.

Quoting as Business Skill Not Administrative Burden

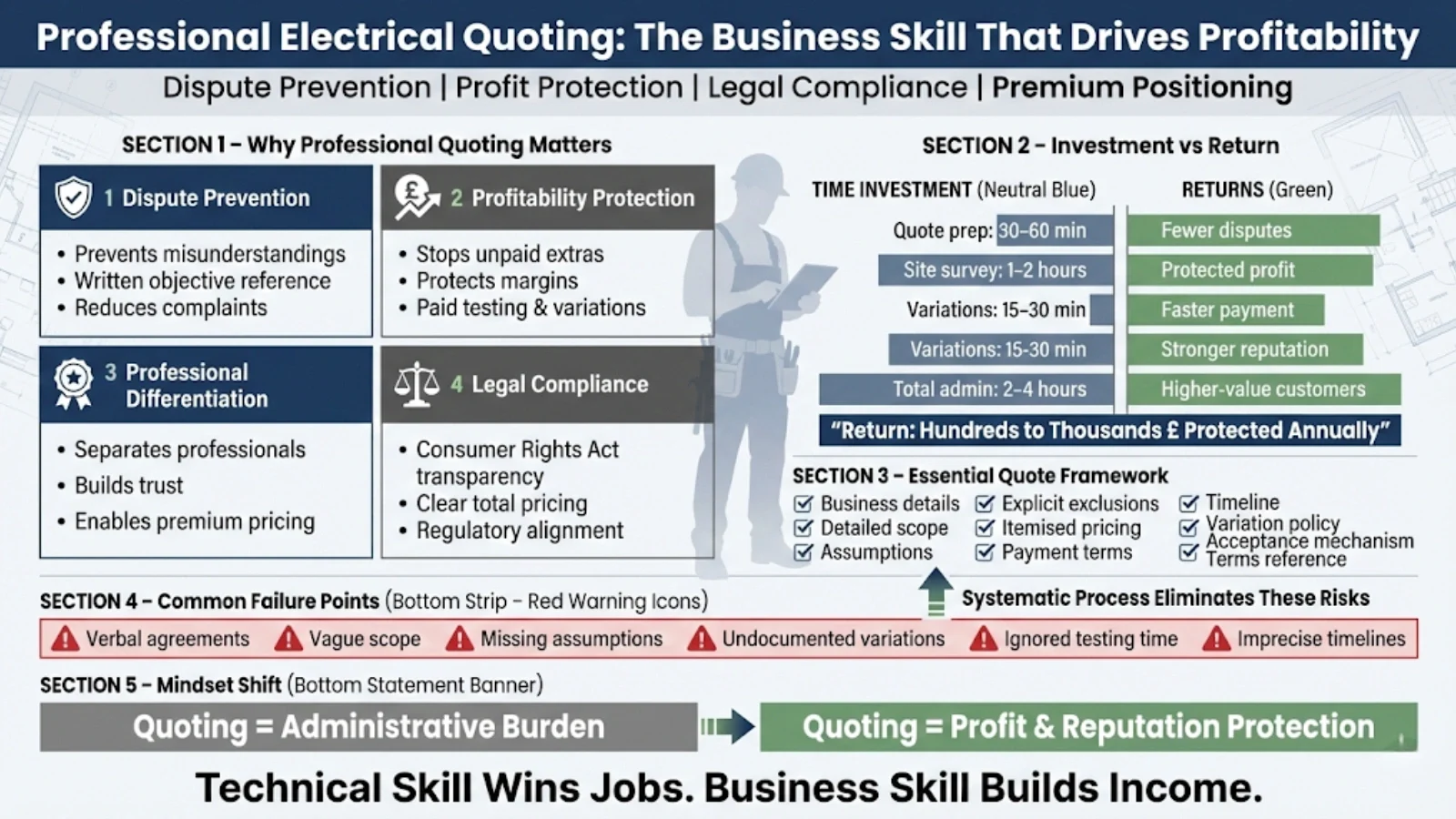

Professional quoting represents business competency as critical as technical electrical skills.

Why professional quoting matters:

Dispute prevention:

  • Majority of payment problems, customer complaints, and business disputes stem from poor quoting rather than poor workmanship
  • Clear scope, assumptions, and exclusions prevent misunderstandings before work begins
  • Written documentation provides objective reference when disagreements emerge

Profitability protection:

  • Proper quoting prevents unpaid extras and scope creep
  • Testing and certification itemized separately ensures regulatory requirements compensated
  • Variation procedures formalized before work starts maintain margins

Professional differentiation:

  • Detailed quotes separate professionals from “bloke with van” competitors
  • Customers pay premium for electricians demonstrating business competence
  • Professional presentation builds trust before work begins

Legal compliance:

  • Consumer Rights Act 2015 requires price transparency
  • Competition and Markets Authority guidance mandates clear total pricing
  • Professional quotes comply with regulatory requirements

The investment versus return:

Time investment in professional quoting:

  • Initial quote preparation: 30-60 minutes for detailed documentation
  • Site surveys for complex jobs: 1-2 hours
  • Variation documentation: 15-30 minutes per change
  • Total: 2-4 hours additional administration per job

Returns from professional quoting:

  • Reduced disputes saving hours of negotiation and stress
  • Proper payment for all work including testing and variations
  • Higher customer satisfaction from clear expectations
  • Professional reputation attracting premium customers
  • Reduced payment delays from documented agreements
  • Value: Hundreds to thousands of pounds per year in protected earnings

Essential elements every professional quote requires:

  1. Complete business details and quote identification
  2. Detailed scope defining every aspect of work
  3. Assumptions clarifying baseline conditions
  4. Exclusions explicitly stating what’s NOT included
  5. Transparent pricing with itemization
  6. Clear payment terms and structure
  7. Timeline estimates and proposed dates
  8. Variation policy for handling changes
  9. Formal acceptance mechanism
  10. Terms and conditions reference

Critical distinctions to understand:

Estimate vs Quotation:

  • Estimates non-binding for uncertain work
  • Quotations binding contracts for defined scope
  • Choose appropriate document type for situation
  • Clearly label which you’re providing

Risk management without padding:

  • Staged quoting for high uncertainty
  • Provisional sums for unknown elements
  • Clear variation procedures stated upfront
  • Site surveys before final quotes on complex work
  • Conditional acceptance clauses protecting both parties

Common failure points to avoid:

  1. Verbal agreements without written confirmation
  2. Vague scope descriptions enabling disputes
  3. Missing assumptions about site conditions
  4. Undocumented variations done as “favors”
  5. Underestimating testing and certification time
  6. Imprecise timeline commitments

The professional mindset shift:

Successful self-employed electricians recognize quoting as:

  • Not: Administrative burden delaying “real work”
  • But: Essential business skill protecting profitability and reputation

Customers choosing electricians based on professional quote quality, not just lowest price. Detailed quotes communicate competence, reliability, and trustworthiness more effectively than vague prices and promises.

Time invested in professional quoting returns many times over through dispute prevention, proper payment for all work, and professional reputation building.

For electricians transitioning to self-employment or refining business practices, prioritizing quote development as highly as technical skill development accelerates business success. The electricians earning £50,000-£70,000 self-employed aren’t necessarily most skilled technically – they’re often ones who mastered business fundamentals including professional quoting enabling them to charge appropriately and avoid unpaid work.

Professional quoting isn’t about defensive language protecting electricians at customer expense. It’s about creating clarity, transparency, and mutual understanding benefiting both parties. Customers receive exactly what they’re paying for. Electricians get paid for all work performed. Disputes minimize. Professional relationships strengthen.

Every electrician should ask themselves: “Would I accept this quote if I were the customer?” If unclear scope, missing assumptions, or vague terms would concern you as customer, improve the quote. Professional quoting creates confidence both parties appreciate.

Business infographic chart illustrating how professional electrical quoting improves dispute prevention, profitability, legal compliance, and premium positioning
Professional quoting transforms electrical expertise into protected profit, regulatory compliance, reduced disputes, and long-term business growth

FAQs

What’s the difference between an estimate and a fixed-price quote, and when should each be used?

An estimate is a best-guess cost based on limited information and allows for change as more details emerge. It’s suitable for early discussions or complex work where conditions are unknown, such as initial surveys for older properties or partial rewires.

A fixed-price quote commits to a set price for clearly defined work, assuming no unforeseen issues. This works best for straightforward jobs with a known scope, such as a consumer unit replacement, and helps set firm expectations while demonstrating professionalism and BS 7671 compliance.

What information should an electrician gather before issuing an accurate domestic quote?

To quote accurately, electricians should gather:

  • Property access details and occupancy
  • Age and type of existing wiring
  • Consumer unit type and condition
  • Earthing and bonding arrangements
  • Customer requirements and future plans
  • Room layouts and appliance loads
  • Any associated building work

A pre-quote site visit is often essential, particularly for Part P notifiable work. In a typical three-bedroom house, allowing 2–4 hours for assessment helps avoid underquoting and later disputes.

How should scope be defined to stop customers assuming extras are included?

Scope should be written as a clear, itemised list of what is included, covering:

  • Specific tasks
  • Materials supplied
  • Work stages (first fix / second fix)
  • Number and type of circuits or points

For example, stating that a quote includes wiring for a kitchen extension but excludes appliance connection prevents assumptions. Clear scope definition limits scope creep and protects both parties.

What assumptions should be written into a quote to manage hidden risks?

Assumptions should clarify that pricing is based on:

  • Visible conditions only
  • Standard access and working hours
  • Existing wiring, earthing, and bonding being compliant unless proven otherwise
  • No requirement for structural alterations

In older UK properties, this is critical. If faults such as degraded wiring or asbestos are uncovered, assumptions allow for fair variations rather than disputes.

What exclusions should always be clearly stated?

Common exclusions include:

  • Making good plasterwork or decorating
  • Removal or disposal of old fittings
  • Specialist waste disposal
  • Out-of-hours or emergency work
  • Additional certification beyond standard electrical certificates

Clear exclusions stop misunderstandings and keep the quote focused on electrical work only.

How should inspection, testing, and certification be included and explained?

Inspection, testing, and certification should be itemised separately, typically allowing 1–3 hours depending on job size.

Explain that this includes:

  • Visual inspection
  • Dead and live testing
  • Verification to BS 7671
  • Issuing the appropriate certificate (e.g. EIC, MEIWC)

This transparency helps customers understand that certification is a legal and safety requirement, not an optional add-on.

How should variations or extra work be handled once a job has started?

All variations should be:

  • Confirmed in writing
  • Priced before work continues
  • Linked to time and material changes

For example, adding extra sockets mid-job might be quoted at £50–£150 per point, including testing. Written variation orders prevent disputes caused by verbal agreements.

What payment terms work best for UK domestic jobs?

A common and effective structure is:

  • 20–30% deposit upfront
  • Stage payments at defined milestones
  • Final balance on certification

Example for a £2,000 kitchen rewire:

  • £500 deposit
  • £800 after first fix
  • £700 on completion and certification

This protects cash flow while reassuring the customer.

How should electricians quote for uncertain work like fault-finding?

For uncertain work, use:

  • Day rates or hourly rates (e.g. £300–£500 per day)
  • Estimated time ranges (e.g. 2–6 hours)
  • Provisional sums where upgrades may be required

Make it clear that older installations may reveal additional issues, such as the need for RCD protection or a new consumer unit, with costs discussed as they arise.

What quoting mistakes most often lead to disputes or lost profit?

The most common mistakes are:

  • Underallowing time for testing and certification
  • Failing to list exclusions and assumptions
  • Not pricing or documenting variations
  • Quoting without a site visit
  • Weak or unclear payment terms

These errors often result in unpaid extras, late payments, or reduced margins. Detailed, assumption-based quotes are essential for protecting profitability and maintaining professional credibility.

References

Note on Accuracy and Updates

Last reviewed: 16 February 2026. This page is maintained; we correct errors and refresh guidance as consumer protection regulations, professional standards, and industry practices evolve. Consumer Rights Act 2015 and Competition and Markets Authority guidance current as of February 2026 but subject to regulatory updates. Professional quoting practices reflect current industry standards from NICEIC, ECA, and trade body guidance. Example prices and payment terms illustrative only; actual pricing varies by region, job complexity, and market conditions. Legal distinctions between estimates and quotations based on UK contract law but specific situations may require professional legal advice. This guide provides professional best practices not formal legal advice; electricians should consult solicitors for specific legal questions. BS 7671 testing requirements current as of 2018+A2:2022 but subject to future amendments. Building Regulations references current for England and Wales; Scotland and Northern Ireland have separate regulatory frameworks. Next review scheduled following significant changes to consumer protection legislation or industry professional standards.

Learners are Studying level 2 Electrician Course

Guaranteed Work Placement for Your NVQ

No experience needed. Get started Now.

Prefer to call? Tap here

Learners are Studying level 2 Electrician Course

Guaranteed Work Placement for Your NVQ

No experience needed. Get started Now.

Prefer to call? Tap here

Learners are Studying level 2 Electrician Course

Guaranteed Work Placement for Your NVQ

No experience needed. Get started Now.

Prefer to call? Tap here

Learners are Studying level 2 Electrician Course

Guaranteed Work Placement for Your NVQ

No experience needed. Get started Now.

Prefer to call? Tap here

Enquire Now for Course Information
